Light Steel Framing for Toronto Multiplexes: The Complete Guide

By Afshin Nabavi, President, Broker of Record, Land Consultant

July 26, 2026 · 13 min read

Light steel framing gets confused with heavy structural steel, but for a Toronto multiplex the real decision turns on OBC storey and area thresholds, insurance pricing, and panel lead times, not marketing copy.

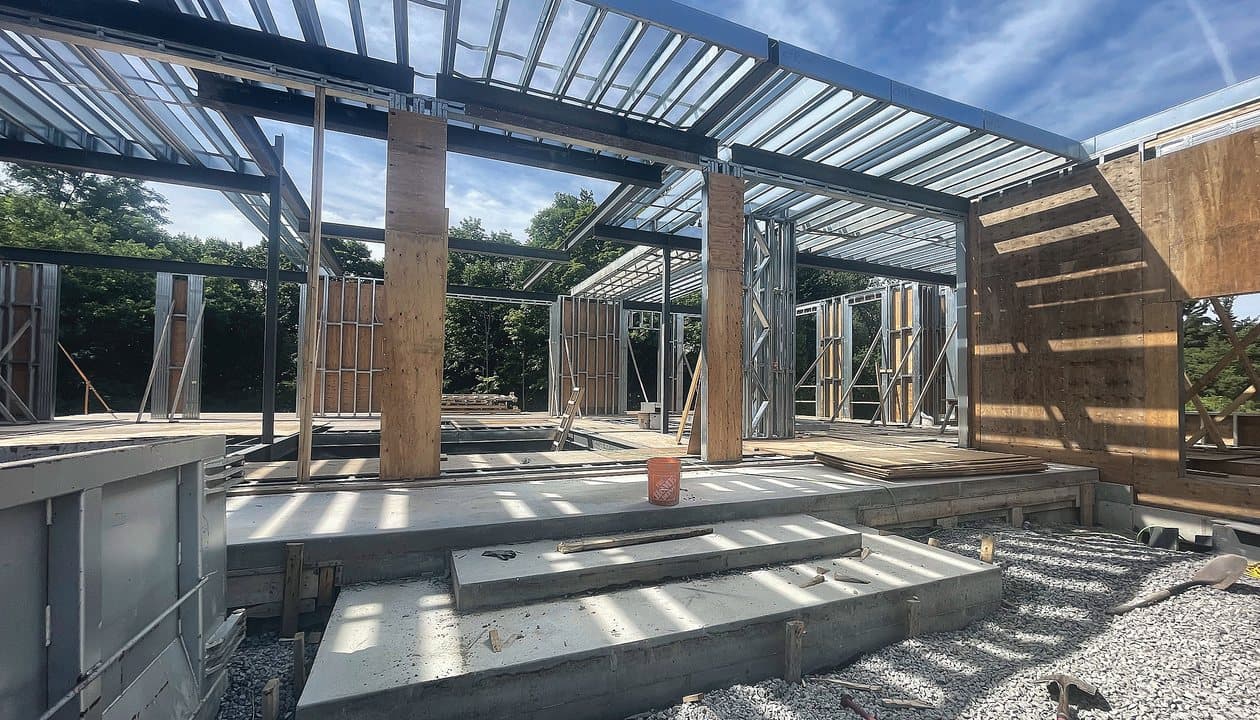

Light Steel Framing for Toronto Multiplexes: The Complete Guide

Light steel framing (LSF) is cold-formed steel: thin-gauge C-shaped studs and track roll-formed from sheet steel, used in place of wood studs. It is not the same product as heavy structural steel, the hot-rolled beams and columns that carry a building's primary frame in taller or larger buildings. On a Toronto multiplex, the choice between LSF and wood turns on two things: whether the Ontario Building Code pushes the project from Part 9 into Part 3, and whether a materials cost premium is offset by insurance pricing and schedule. Both are knowable before a shovel goes in the ground.

What Light Steel Framing Actually Is

LSF studs and track are roll-formed from thin-gauge sheet steel into a C-shaped profile, then screwed together on site or in a panel shop. The geometry matches a 2x4 or 2x6 wood stud wall; the material simply doesn't burn. The Canadian Sheet Steel Building Institute (CSSBI), the industry association for sheet steel products, publishes design guidance for cold-formed steel framing members; member design itself follows CSA S136, the North American specification the Building Code references. That distinction is worth stating plainly, because search results for "light steel framing" routinely blend in heavy-gauge structural steel and pre-engineered steel buildings, which are a different design problem with a different cost structure. LSF is a stud-and-track substitution, not a structural steel frame.

Why Light Steel Framing Is Showing Up on More Toronto Multiplex Jobs

The short answer is that there are simply more multiplex jobs to frame. Since May 10, 2023, Toronto's Official Plan and Zoning By-law amendments have permitted duplexes, triplexes and fourplexes as-of-right, with no rezoning application, on any residential lot zoned R, RD, RS, RM or RT under the city's Neighbourhoods designation. Six units is a narrower permission: it currently applies as-of-right only to a detached building, and only in the Toronto and East York District, adopted by City Council on June 25 to 26, 2025, and in Ward 23 (Scarborough North), adopted February 5, 2025. A citywide expansion of the six-unit permission to all low-rise neighbourhoods has not been adopted. Outside the TEY district and Ward 23, four units remains the as-of-right ceiling.

More multiplex permits means more small-scale developers and homeowners running a framing decision they have not run before, and two pressures are pushing some of them toward steel. First, panelization: prefabricated wall panels, steel or wood, can compress the enclosure phase of a build, which matters on a construction loan with a defined draw schedule. Second, insurance: the CSSBI, the industry association for cold-formed steel, has published analysis arguing that the cost gap between steel and wood narrows, and in some comparisons reverses, once builder's-risk insurance premiums are counted. The reasoning: noncombustible steel framing typically qualifies for lower insurance rates than combustible wood framing. That claim comes from a single industry association, not independently corroborated by a second Canadian source. Treat it as directional industry commentary, not a verified benchmark, and price it for your own project before betting a pro forma on it.

Light Steel Framing vs Wood, Mass Timber, and Concrete

Here is how the four structural systems compare on the variables that actually decide a Toronto multiplex file: where each one sits in the code, whether it is combustible, what its sprinkler and fire-separation status is, and where the cost data stands.

System Where it fits in the OBC Combustibility Sprinkler / fire-separation status Cost position
Wood frame (2x6) Part 9: up to 3 storeys and 600 m² (6,458 ft²) of building area; in Part 3, sprinklered wood frame is permitted for residential buildings up to 6 storeys Combustible No sprinkler or encapsulation rating required under Part 9 generally, though a loadbearing wall carrying a required fire separation between stacked dwelling units may have its own combustibility requirement independent of the building's overall Part 9 classification; confirm with your code consultant Industry baseline; no encapsulation cost, except where a stacked-unit loadbearing wall needs a rated protective assembly, price that wall as its own line
Light steel framing (CFS) Fits either Part 9 or Part 3 scale; the framing material itself does not change which part applies Noncombustible Follows the host building's Part 9 or Part 3 classification; a Part 3 steel building's sprinkler and fire-separation requirements depend on the specific OBC 3.2.2 occupancy classification, confirm with your code consultant Often higher material cost upfront than wood; the gap can narrow once builder's-risk insurance is priced in, per CSSBI (single-source, directional only)
Mass timber (EMTC) Part 3 only; up to 18 storeys for some Group C and Group D occupancies as of January 1, 2025 Engineered combustible, encapsulated Full sprinklering to NFPA 13 required; floor assemblies generally need a minimum 2-hour fire-resistance rating as a fire separation, with a limited exception for floors inside individual dwelling units of 6 m (19'-8") or less internal rise No independently verified Canadian $/sq ft benchmark for a Toronto multiplex found in current research
Concrete Part 3 Noncombustible Same as steel: OBC 3.2.2 occupancy-specific, confirm with your code consultant Not covered by the cost data behind this article; get a project-specific quote

Span capacities for LSF studs and track are gauge- and spacing-dependent; they're engineered per project against CSSBI design guidelines, not read off a single universal table. Treat any generic span number you see quoted online with caution, and confirm it against your own structural engineer's calculations.

When Does the Ontario Building Code Push a Multiplex Into Steel?

This is the trigger that actually matters, more than any marketing claim about steel being "code-friendlier." Under Part 9 (Housing and Small Buildings) of the OBC, a Group C residential building (other than a retirement home) qualifies for the simpler Part 9 prescriptive path, which permits combustible wood-frame construction without an encapsulation rating, only if it is up to 3 storeys in building height and has a building area of 600 m² (6,458 ft²) or less. At three storeys or fewer and a building area within that limit, LSF is a framing choice, not a code requirement; wood and steel are both viable structurally, and the decision comes down to cost and insurance. Exceed either threshold, or add an assembly occupancy, and the project falls out of Part 9 into Part 3, an engineered path that generally requires design and general review by an architect and a professional engineer under Division C of the OBC.

One Part 9 nuance is worth flagging on its own, because it's easy to read the 3-storey, 600 m² (6,458 ft²) threshold as settling the combustibility question for the whole building: where a multiplex stacks dwelling units one above another, the assembly separating those units is a required fire separation, and the OBC's general rule for loadbearing construction is that a wall, column or other support carrying a required fire separation has to provide a fire-resistance rating matching that separation. Depending on the specific stacked-unit configuration, this can mean the loadbearing wall itself needs to be noncombustible even though the building as a whole stays inside Part 9's 3-storey limit; a wood loadbearing wall that reaches the required rating through an encapsulating assembly is not automatically the same thing as meeting a noncombustibility requirement. Confirm this against the current OBC provisions for your exact unit stacking with your code consultant before assuming a Part 9 classification clears every wall in the building, not just the ones a generic 3-storey summary covers.

Part 3 does not, by itself, force steel. A sprinklered residential building of up to six storeys can still be framed in wood; Part 3 also opens the door to noncombustible construction (steel, concrete) and to engineered combustible construction under the encapsulated mass timber construction (EMTC) provisions. EMTC was first permitted in the OBC effective July 1, 2022, at a maximum height of 12 storeys, then expanded effective January 1, 2025 (2024 OBC, O.Reg. 163/24 as amended by O.Reg. 447/24) to a maximum of 18 storeys for some Group C and Group D occupancies, with maximum building areas up to 6,000 to 7,200 m² (64,583 to 77,500 ft²). One rule holds across all Part 3 systems, not just EMTC: once a building is more than 3 storeys or 14 m (45'-11") in height, measured between grade and the ceiling of the top storey, it needs a standpipe system, regardless of whether the structure is steel, concrete, or timber. For EMTC specifically, full sprinklering to NFPA 13 and minimum 2-hour fire-resistance-rated floor separations are mandatory. For a Part 3 steel or concrete multiplex, the sprinkler and fire-separation package is set by the specific OBC 3.2.2 classification for that occupancy and configuration, not by a blanket Part 3 rule, so run that with your code consultant before pricing it.

A Cost Breakdown: Framing a Toronto Sixplex in Steel vs Wood

A detached six-unit building in the Toronto and East York District or Ward 23 is held to a height limit in metres rather than a set number of storeys, and under the building code it leaves Part 9 once it passes three storeys or 600 square metres (6,458 ft²) of building area. Once it is a Part 3 project, the framing decision sits inside an engineered, reviewed design regardless of material. The cost comparison between steel and wood on that shell breaks into four lines worth pricing separately rather than assuming a single blended number:

  • Material and labour. Cold-formed steel framing is generally reported as costing more upfront than 2x6 wood framing per square foot in Canada, but the size of that premium varies by region, project scale, and lumber market conditions; no single verified Canadian benchmark figure exists. Get a current quote from a licensed cost consultant instead of relying on a generic industry number.
  • Insurance. The CSSBI's own analysis is that the wood-to-steel cost gap narrows, and in some comparisons reverses, once builder's-risk insurance is added, because noncombustible steel typically prices lower than combustible wood on that line. Run both scenarios through your broker before deciding this is the tiebreaker.
  • Engineering and code review. A Part 3 building requires design and general review by an architect and a professional engineer. That's an added scope line that applies to the shell regardless of which structural material is chosen, so it isn't steel-specific, but it belongs in the same budget line as the framing decision.
  • Loadbearing wall combustibility. Where stacked units push a loadbearing wall toward a noncombustible requirement even inside Part 9 (see above), the comparison on that specific wall isn't a two-way LSF-versus-wood one, it's a three-way one: wood framing carrying a noncombustible-rated protective assembly on the loadbearing wythe, versus LSF, versus a cast-in-place or block concrete loadbearing wall. No verified Canadian per-square-foot benchmark exists for that three-way comparison at multiplex scale; price all three against your own drawings with a licensed cost consultant rather than assuming LSF's usual materials premium over plain wood framing still holds once a rated assembly is added to the wood option.

No verified Canadian benchmark exists for mass timber package and enclosure costs on a multiplex like this one. A specific mass-timber $/sq ft figure for a Toronto sixplex should come from a current Canadian cost consultant's published guide, not a generic online figure.

How Many Weeks Does Panelization Actually Save?

Panelization means building wall assemblies in a shop and craning them into place, rather than stick-framing on site. It's a fabrication method, not something exclusive to steel: wood panels are prefabricated the same way. The schedule case for it comes from vendor-reported project examples, not an audited industry-wide average. PrimeFab, an Ontario-based prefabricated panel supplier, reports enclosing a 2,100-sq-ft home in three days, versus an estimated three weeks for conventional site framing. On a roughly 4,000-sq-ft addition project using 103 prefabricated panels, PrimeFab reports full installation in three days and complete enclosure, including roof trusses, in one week. Those are named case studies showing what panelization can do on a residential-scale project, not measurements taken on an LSF job specifically. Read them as a range to test against your own fabricator's quote, not a guaranteed outcome. On a construction loan with interest accruing from first draw, a shorter time to closed-in shell shortens the interest-carry window; it also means the panel order has to be locked and paid for earlier in the schedule, which shifts cash-flow timing rather than eliminating cost.

Where Light Steel Framing Underperforms

Three variables decide whether steel actually wins on schedule or cost, and none of them are fixed numbers you can look up once and reuse across projects. Price and confirm each one directly with your fabricator and engineer:

  • Thermal performance. Steel conducts heat where wood does not, so an LSF wall assembly needs a deliberate thermal-break strategy, typically continuous exterior insulation, to hit the same effective wall R-value as a comparable wood assembly. Confirm the assembly's tested or calculated effective R-value with your building envelope consultant rather than reading it off the nominal cavity insulation number.
  • Engineering and shop-drawing turnaround. Part 3 review by an architect and professional engineer applies to the shell regardless of material, but panelized systems add a shop-drawing step between structural design and fabrication. Ask your fabricator directly what their current shop-drawing turnaround is and build that into your permit-to-panel timeline rather than assuming it is instant.
  • Panel lead time and crew availability. Panel shop capacity and crew booking windows move with steel mill output and regional demand. Before you build a construction schedule around a panelization time saving, get your fabricator's current lead time in writing and confirm they have a crew booked for your erection window, not just a quote.

None of these rule out steel; they are the specific numbers that decide whether the schedule and thermal-performance case for LSF holds on your project, and they need to be checked against a current quote, not assumed.

A Decision Test for Toronto Multiplex Projects

  1. Is the project inside Part 9? Up to 3 storeys, building area of 600 m² (6,458 ft²) or less, Group C residential. If yes, wood and LSF are both structurally viable and the decision is cost and insurance, not code, with one exception: where units are stacked, check whether the loadbearing wall carrying that fire separation has to be noncombustible in its own right, and price that wall as its own line rather than folding it into the general wood-versus-steel comparison.
  2. Does the project cross into Part 3? More than 3 storeys, more than 600 m² (6,458 ft²) of building area, or an assembly occupancy. If yes, design and general review by an architect and professional engineer is required, and the construction type follows OBC Subsection 3.2.2: sprinklered wood frame is permitted for residential buildings up to six storeys, alongside steel, concrete and encapsulated mass timber.
  3. Is the building over 3 storeys or 14 m (45'-11")? Then a standpipe system is required no matter which structural material is chosen; do not price that as a steel-specific cost.
  4. Have you priced builder's-risk insurance for both a wood and a steel scenario? The CSSBI's own data suggests this is where the cost gap moves most, not the raw material price; get both quotes before deciding.
  5. Have you confirmed panel lead time and shop-drawing turnaround against your loan's draw schedule? Panelization can compress the enclosure phase on the vendor case studies available, but only if the shop is not backlogged when your project needs panels.
  6. Does your financing depend on unit count and points, not framing material? CMHC's MLI Select insured multi-unit product requires a minimum of 5 units and runs on a tiered points system: at 50 points, up to 85% LTV on existing properties or up to 95% LTC on new construction with amortization up to 40 years; at 70 points, up to 95% LTV with 45-year amortization; at 100 points, up to 50-year amortization, with a minimum debt coverage ratio of 1.10 for standard rental housing. That points system is built on affordability, accessibility and energy performance, not structural material, so LSF is neither required nor rewarded to qualify. MLI Select is a CMHC-administered insurance product. TESA does not broker or arrange mortgage financing; we coordinate with licensed lenders on the capital stack.

How TESA Specs and Sequences Light Steel Framing

We run the framing decision as part of feasibility, not after it. On a multiplex file, we confirm the Part 9 or Part 3 classification first, because that determines whether wood is even on the table and whether a professional engineer needs to be in the design from day one. Where a project sits inside Part 9, we price both a wood and a light steel framing package against the same drawings and let the materials and insurance numbers decide, rather than defaulting to one system. Where a project is pushed into Part 3 by storey count, building area, or an assembly occupancy, we bring in the architect and professional engineer the OBC requires. Then we sequence shop drawings and panel fabrication against the construction loan's draw schedule, so a panelization schedule gain doesn't get quietly lost behind a permit or an engineering review. That sequencing, not the framing material by itself, is usually what decides whether a multiplex shell closes in on time.

Common questions

What is light steel framing, and is it the same as structural steel?

No. Light steel framing (LSF) is cold-formed steel (CFS) framing, thin-gauge C-shaped studs and track roll-formed from sheet steel, used in place of wood studs. It is a distinct product from heavy structural steel, the hot-rolled beams and columns used for a building's primary structural frame in taller or larger buildings.

How many units can I build as-of-right on a Toronto residential lot?

Up to four units (duplex, triplex, or fourplex) citywide on Neighbourhoods-designated lots in the R, RD, RS, RT and RM zones, as of May 2023. Five or six units in a single detached building are as-of-right only in nine wards: the eight Toronto and East York district wards since June 2025 and Ward 23 (Scarborough North) since February 2025. The building is capped by height in metres, not by a storey count. Council held off on a citywide expansion and asked for a further report back in 2027.

Is light steel framing cheaper than wood framing for a Toronto multiplex?

It depends what's counted. Industry data from the Canadian Sheet Steel Building Institute suggests steel framing often costs more upfront on materials, but the gap can narrow or reverse once builder's-risk insurance, typically lower for noncombustible steel, is included. No independently verified Canadian $/sq ft benchmark for a Toronto multiplex was found in current research; get a quote from a licensed cost consultant before relying on a published figure.

Does CMHC MLI Select financing require a specific construction method?

No. MLI Select is a CMHC-insured multi-unit financing product based on unit count (minimum 5 units) and a points system covering affordability, accessibility and energy efficiency. It does not mandate light steel framing, wood, or mass timber. TESA does not arrange or broker MLI Select or any other mortgage financing; it coordinates with licensed lenders.

At what point does the Ontario Building Code push a Toronto multiplex out of the simpler Part 9 rules?

Once the building exceeds 3 storeys in building height or 600 m² (6,458 ft²) in building area, or includes a use Part 9 does not cover such as an assembly occupancy, it moves from Part 9 to Part 3 of the Ontario Building Code. Part 3 brings in design and general review by an architect, a professional engineer, or both. It does not force noncombustible construction: the Code allows sprinklered wood-frame residential buildings up to 6 storeys.

How tall can a mass timber building be built in Ontario right now?

Up to 18 storeys for certain residential (Group C) and office (Group D) buildings, in force since January 1, 2025 under Ontario's Building Code. The previous limit was 12 storeys, in place from July 1, 2022.
